The team produced a Level of Service (LOS) report for both intersections before and after installing our proposed improvements. The reports was generated through SimTraffic, which simulated the operating conditions during our study scenarios. The City of Irvine sets the goal LOS to be D. Before installing our proposed improvements, California Ave/Academy Way performed at LOS D during the AM time period and LOS E during the PM time period, while California Ave/Innovation Dr performed at LOS F during both the AM and PM time periods. From this analysis, the team suggested improvements to both intersections to improve the LOS to achieve the City of Irvine's goal LOS of D.
California Ave/Academy Wy is currently a 4-way intersection with a traffic signal. The team proposes to install a right turn overlap on the west-bound right turn approach. In tandem, the team also proposes to prohibit u-turns for the south-bound left turn approach to prevent potential vehicle conflicts.

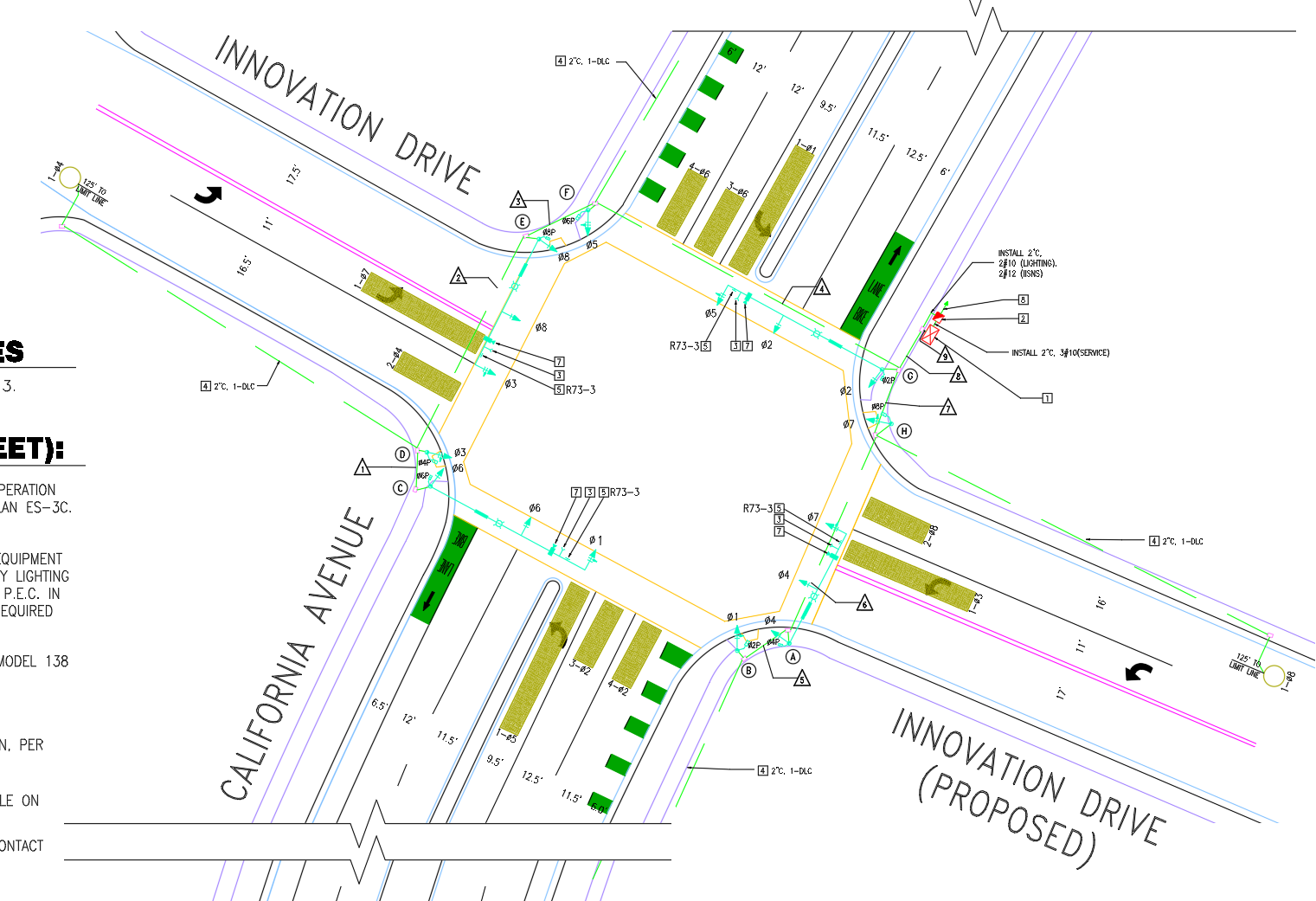

California Ave/Innovation Dr is currently a intersection with stop signs on the minor street. The team proposes to install a 4-way traffic signal at California Ave/Innovation Dr. A traffic signal plan and a signing and striping plan was drafted to depict the proposal.
After installing these two proposed improvements, California Ave/Academy Way performed at LOS D during both the AM and PM time period , while California Ave/Innovation Dr performed at LOS C during the AM time period and LOS B during the PM time period.
The team created a Gantt Chart outlining the project schedule. From the design to construction phase, the project is projected to last 48 weeks.
The team also estimated the cost of installing these proposed improvements, which is projected to be around $485,000.
Due to the limited resources and time of this project, the team identified additional studies and potential recommendations for the client to conduct before and after installing the proposed improvements. Such studies include a parking study, a line of sight study, fair-share analysis, air quality study, noise pollution study, and a post-construction performance review.
